WMS Implementation Plan: Blueprint, KPIs, and Best Practices

Implementing a Warehouse Management System (WMS) is one of the most impactful decisions a warehouse can make.
A well-planned WMS improves accuracy, reduces operational waste, increases visibility, and brings structure to every
warehouse process. However, a WMS is not just a software installation — it is an organizational transformation.
Successful implementation depends on preparation, clear roles, accurate master data, disciplined execution, and measurable KPIs.

Many SMEs ask whether a WMS is too complex or too costly for their warehouse. The truth is that the success of a WMS
depends far more on planning than on budget. A warehouse with clear processes, consistent storage logic, accurate product data,
and trained operators will always implement a WMS faster and more effectively. The purpose of this page is to provide a practical,
structured guide to help SMEs prepare, plan, and evaluate a WMS implementation from a strategic and operational perspective.

1. A Practical Blueprint Structure for SMEs

A WMS Blueprint should be simple, visual, and operational — not a theoretical document.
A strong blueprint typically contains:

  • Process Mapping (Receiving → Putaway → Picking → Packing → Dispatch)
  • Location architecture (aisles, levels, zones, pick faces, reserve)
  • Product Attributes Model (dimensions, pick units, replenishment rules)
  • Exception Scenarios (damaged goods, stock differences, partial pallets)
  • Operator Roles and Access Rights
  • Equipment & Device Mapping (scanners, printers, forklifts)
  • KPIs & Reporting Needs
  • Integration Requirements (ERP, TMS, Labeling, Accounting)

SMEs often ask how detailed a blueprint should be.
Answer: Just detailed enough to ensure consistency — not so complex that nobody reads it.

2. Project Objective

The goal of a WMS implementation is to automate critical warehouse operations and align them with ERP,
transportation, and courier systems.

Key expected benefits:

  • Increased efficiency in receiving, storage, and picking
  • Error reduction in order preparation
  • Real-time visibility of stock and movements
  • KPI-based performance monitoring

3. Scope of Implementation

  • Warehouse type: Traditional (non-automated)
  • Processes covered: Receiving, storage, picking, packing, shipping, returns
  • Integrations: ERP system, courier/TMS

4. Implementation Roadmap (Gantt Chart)

  • Business analysis: July 22 – August 9
  • Blueprint creation: August 10 – 31
  • WMS selection & configuration: September 1 – 20
  • UAT (user acceptance testing): September 21 – October 10
  • Team training: October 5 – 15
  • Go-live & support: October 16 – November 1

wms gantt
wms implementation Gantt diagram

5. Roles & Responsibilities (RACI Matrix)

  • Project Manager: Accountable for approvals, ensures project delivery
  • IT Consultant: Responsible for blueprinting, testing, and support
  • WMS Vendor: Configures, trains, and supports system
  • Operations: Provides input, validates processes
  • Top Management: Oversees and validates key decisions

6. Service Level Agreements (SLA)

SLA TypeKPI ExampleTarget
Delivery time98% of orders shipped within 24h> 98%
Picking accuracyErrors below 0.5%> 99.5%
Receiving timeCompleted in max. 4h95% < 4h
Stock availabilityCoverage of active items> 97%
Returns processingValidated within 48h> 90%

7. RAID Register

  • Risks: Delays in WMS license delivery, lack of operational team involvement
  • Assumptions: Full ERP data access, vendor support available
  • Issues: Misalignment between current processes and WMS standard configuration
  • Dependencies: IT infrastructure readiness, signed vendor contract

8. Automated WMS Processes

  • Receiving with ASN & barcode scanning
  • Automatic slotting (location assignment)
  • Optimized picking (wave, batch, RF scanning)
  • Guided packing & consolidation
  • FIFO/Lot/Expiry traceability
  • Automated cycle counting
  • Courier integration & AWB generation
  • Real-time KPI dashboard & SLA alerts

9. KPI Focus for Picking

Efficient order picking is a cornerstone of WMS performance. Common KPIs include:

  • Picking accuracy (%): error-free order lines vs. total lines
  • Order cycle time: time from order release to completion
  • Lines picked per hour (productivity): average output per operator
  • Orders picked per operator: workload balance
  • Cost per order line picked: efficiency of resources used

These KPIs ensure continuous monitoring and improvement of warehouse operations.

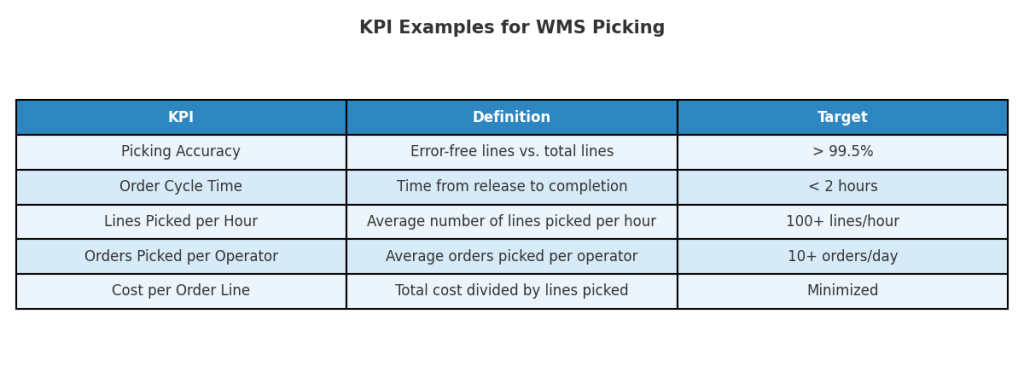

wms picking kpi

Warehouse managers often ask which KPI matters most ?
Answer: Stock accuracy — everything depends on it.

10. Example:

WMS Implementation in a 12-Operator Warehouse

A mid-sized warehouse implemented a WMS over 10 weeks.
Key actions taken:

  • cleaned and standardized location codes
  • consolidated product master data
  • trained operators using real scenarios
  • mapped all exceptions
  • created KPI dashboards
  • tested receiving, picking, and replenishment flows

Results after 6 months:

  • stock accuracy increased from 88% → 98%
  • picking productivity improved by 22%
  • customer complaints dropped by 40%

The example shows that structured preparation is more important than the software itself.

11. The Most Common Implementation Mistakes

  • unclear location architecture
  • incorrect or incomplete product master data
  • insufficient operator training
  • skipping exception scenarios
  • no pilot test or isolated testing
  • poor communication between teams
  • expecting the WMS alone to “fix” process issues

Avoiding these mistakes can reduce implementation time by 20–30%.

Conclusion

A successful WMS implementation plan combines structured project management (Gantt, RACI, RAID),
strict performance targets (SLA), and continuous monitoring through KPIs.
By following this roadmap, companies secure a smooth transition to a digital warehouse environment that
improves accuracy, speed, and scalability.
